Home
All Services →
Truckload
Full Truckload (FTL) Partial Truckload (PTL) Flatbed & Open Deck Refrigerated Freight Power-Only
Specialized
Heavy Haul & Oversized Project Cargo Hazmat Shipping Cross-Border Canada
Time-Critical
Expedited Freight Sprinter Van Box Truck
All Industries →
Heavy Industry
Heavy Manufacturing Steel & Metals Automotive Aerospace & Defense
Energy & Chemicals
Oil, Gas & Petrochemical Chemical & Industrial Energy & Utilities Renewable Energy
Construction & Supply Chain
EPC & Construction Building Materials Food & Beverage Freight Forwarders
All Locations →
Southeast
Birmingham, AL Atlanta, GA Georgia Tennessee Kentucky North Carolina Florida
Midwest
Chicago, IL Ohio Indiana Michigan
Northeast
Pennsylvania New York New Jersey
West & Southwest
Texas Phoenix, AZ California Seattle, WA
About Book Freight Security & Carrier Vetting Resources
Contact (205) 855-6385 Quote Now →
Oversize heavy haul escort convoy moving a 223,000-lb evaporator across the Southwest desert
Project Case Study · Superload

223,000-lb Evaporator: Port of Houston to California

A 48-foot vessel, superload permits in four states, and Book Freight managing the move from ship-side pickup to delivery at an active industrial site in California’s Central Valley.

223,300Pounds101.3 metric tons
48′ 4″Length14.7 m
12′ 9″Widthincl. nozzles
13′ 6″Heighton saddles
12Axlestractor, jeep & 8-line trailer
4Statessuperload permits in each
The Route
Houston, TXShip-side pickup
New MexicoEscorted transit
ArizonaEscorted transit
Central Valley, CADelivered to site
The Challenge

Too big for standard permits. Too sensitive to ride flat.

A falling film water evaporator arrived at the Port of Houston bound for an industrial facility in California’s Central Valley. At 48 feet long, nearly 13 feet wide and about 223,000 pounds empty, it was discharged by the ship’s own heavy-lift cranes directly onto the trailer and moved as a superload in every state on the route.

California’s superload review was the most demanding on the route and needed a longer lead time than any other state on the route. Book Freight managed that timeline end to end, so the customer’s project team always knew where the load stood and when it would arrive.

30°The fabricator’s transport drawing called for the vessel to ship rotated 30° on four custom saddles, positioned to keep its nozzles clear of damage during loading, transit and unloading at site.
Tarped 223,000-lb evaporator secured on transport saddles on a multi-axle heavy haul trailer in the Houston area
Loaded, tarped and secured on transport saddles in the Houston area.
Rolling out: the 12-axle combination pulls onto the highway in the Houston area.
How Book Freight Managed It

Engineered, permitted, and communicated.

01

Engineered equipment

A 12-axle combination (tractor, jeep dolly and an 8-line modular trailer) spread the vessel’s 223,000 pounds across the length of the combination.

02

Four-state permitting

Superload permits in Texas, New Mexico, Arizona and California, coordinated as one timeline, including California’s extended superload review.

03

One point of contact

The shipper got clear, dated updates from port pickup to delivery, with real dates to plan the project around and no guesswork.

04

Delivered to site

The load rolled into an active industrial plant, where the site’s crane crew set it with a two-crane tandem lift.

12-axle heavy haul combination with jeep dolly and 8-line modular trailer carrying a 223,000-lb evaporator
12 axles: tractor, jeep dolly and an 8-line modular trailer.
Heavy haul crew and escort vehicles staged roadside with an oversize evaporator on a multi-axle trailer

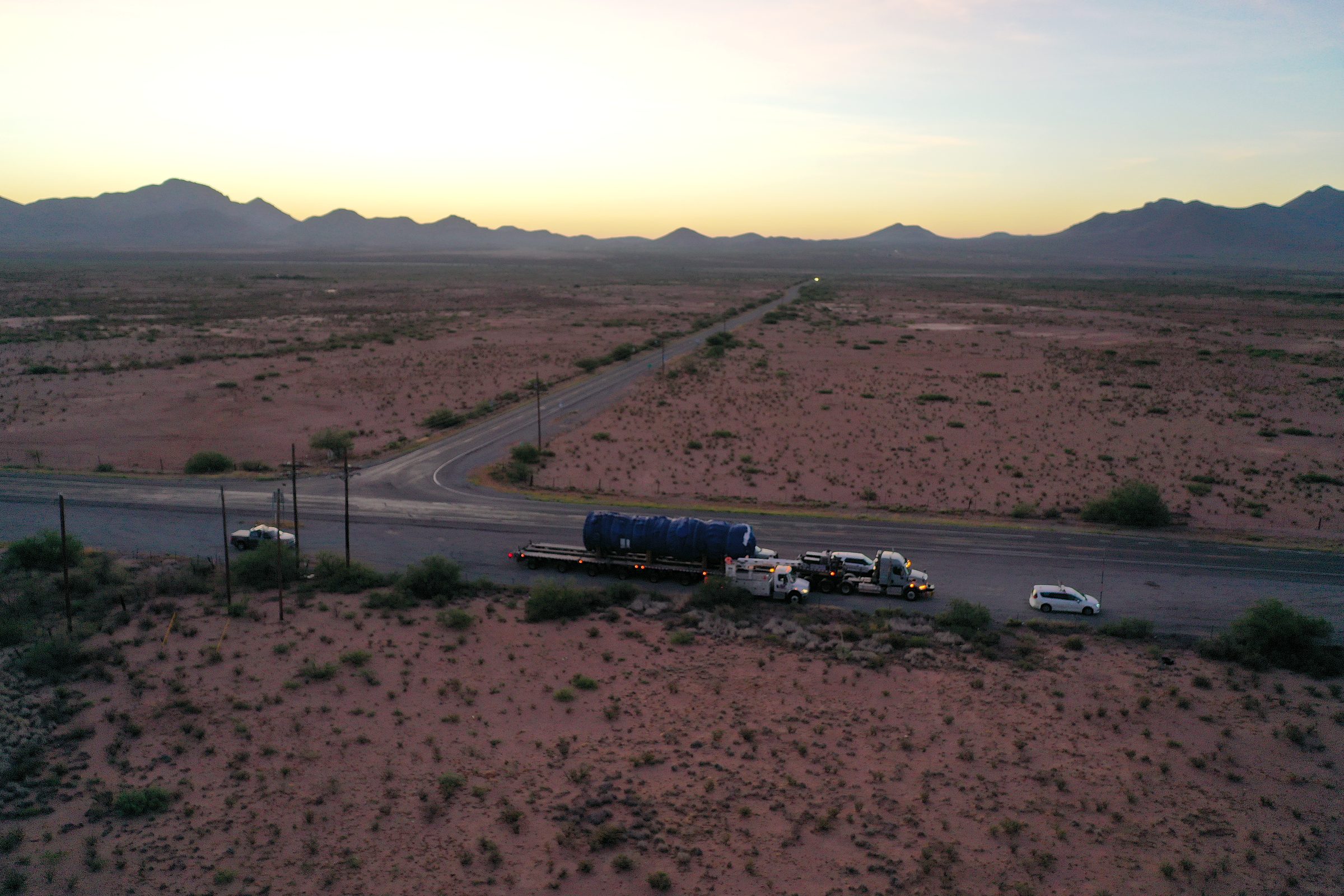

The convoy staged at a scheduled stop in the Southwest.
On the Road

Four states under escort.

The evaporator crossed Texas, New Mexico, Arizona and California in an escort convoy with pilot vehicles, a height-pole car checking overhead clearances, a bucket truck for utility lines, and law enforcement escorts where the permits called for them.

Travel was limited to permitted hours, so the convoy staged on the shoulder at scheduled stops and rolled again when the travel window opened.

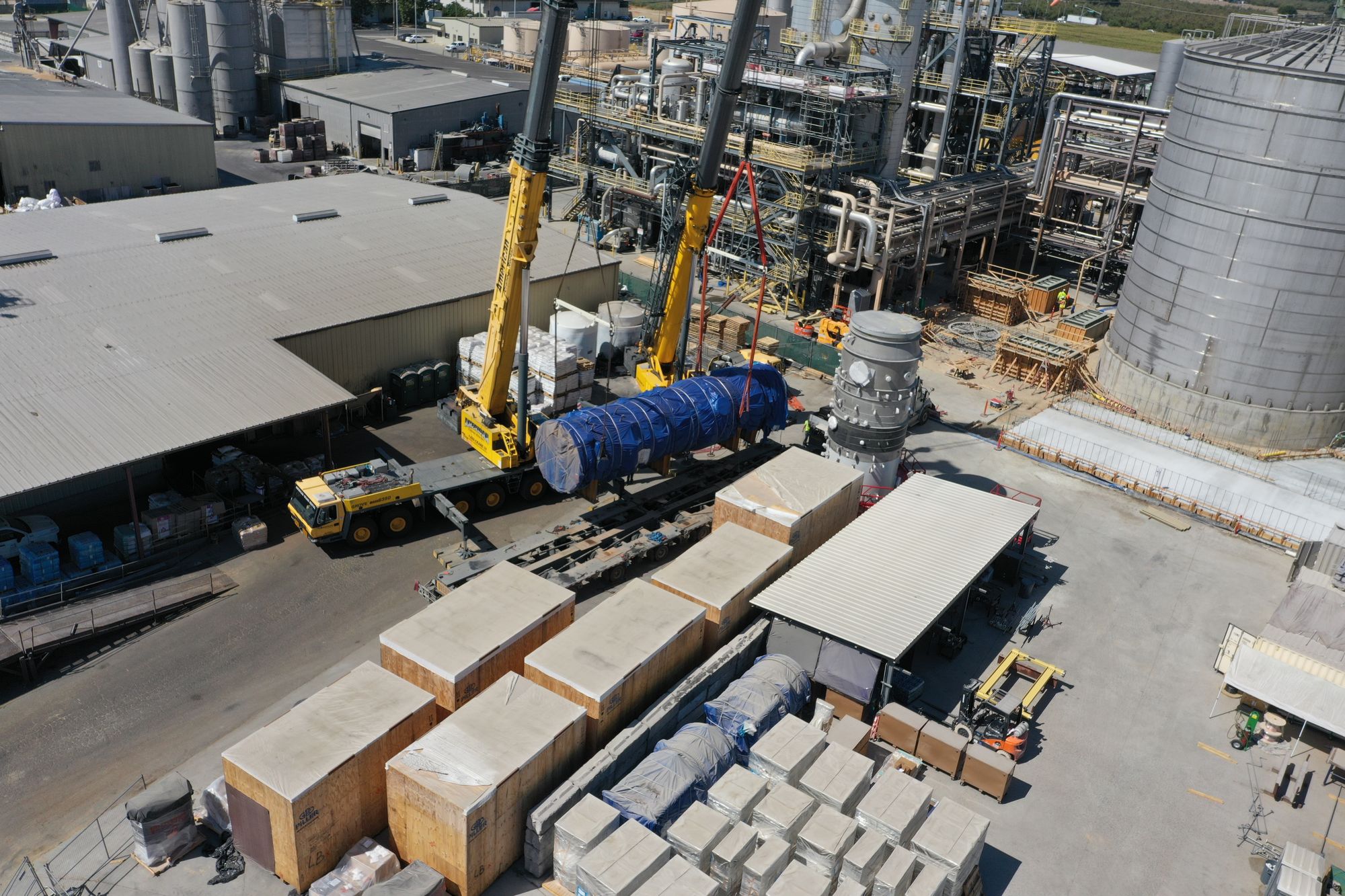

Crane offloading a 223,000-lb evaporator from a heavy haul trailer at an industrial facility in California's Central Valley
The site’s crane crew sets the vessel at the facility in California’s Central Valley.
The Result

Port to site. Handled.

The evaporator reached the facility in California’s Central Valley and was set by the site’s crane crew, completing a four-state superload move from the Port of Houston to site.

Book Freight managed the move from the ship to the plant gate, and the shipper had one point of contact the whole way.

What Shippers Should Know

Moving oversize freight into California? Plan for the permits, not the miles.

  1. Start the permit process as soon as the equipment’s ship date is known.
  2. Build buffer into the project schedule for California’s review. It’s usually longer than the drive.
  3. Get the fabricator’s transport drawing to your broker early. Saddle positions, orientation and center of gravity shape the equipment choice.
  4. Choose a broker who keeps you updated through the whole process, not just at pickup and delivery.

Got a load other brokers bounce?

Send the dimensions, weight and drawings. We’ll tell you what it takes to move it.
